R Avenue re-opened after major renovation
Art Shotwell photo

R Avenue re-opened after major renovation

The city re-opened R Avenue to traffic Friday afternoon after four months of construction that the city says will enhance the roadway for vehicle travel, pedestrians, cyclists and other multi-modal means of transportation, public transit and water quality.

I was on my bicycle when I noticed the city started removing barriers. I grabbed my chance and rode the length of the renovation before traffic (meaning cars) started to flow.

The long-planned project will cost about $5 million, with funding from the federal government, Skagit County and the city's Transportation Improvement Board.

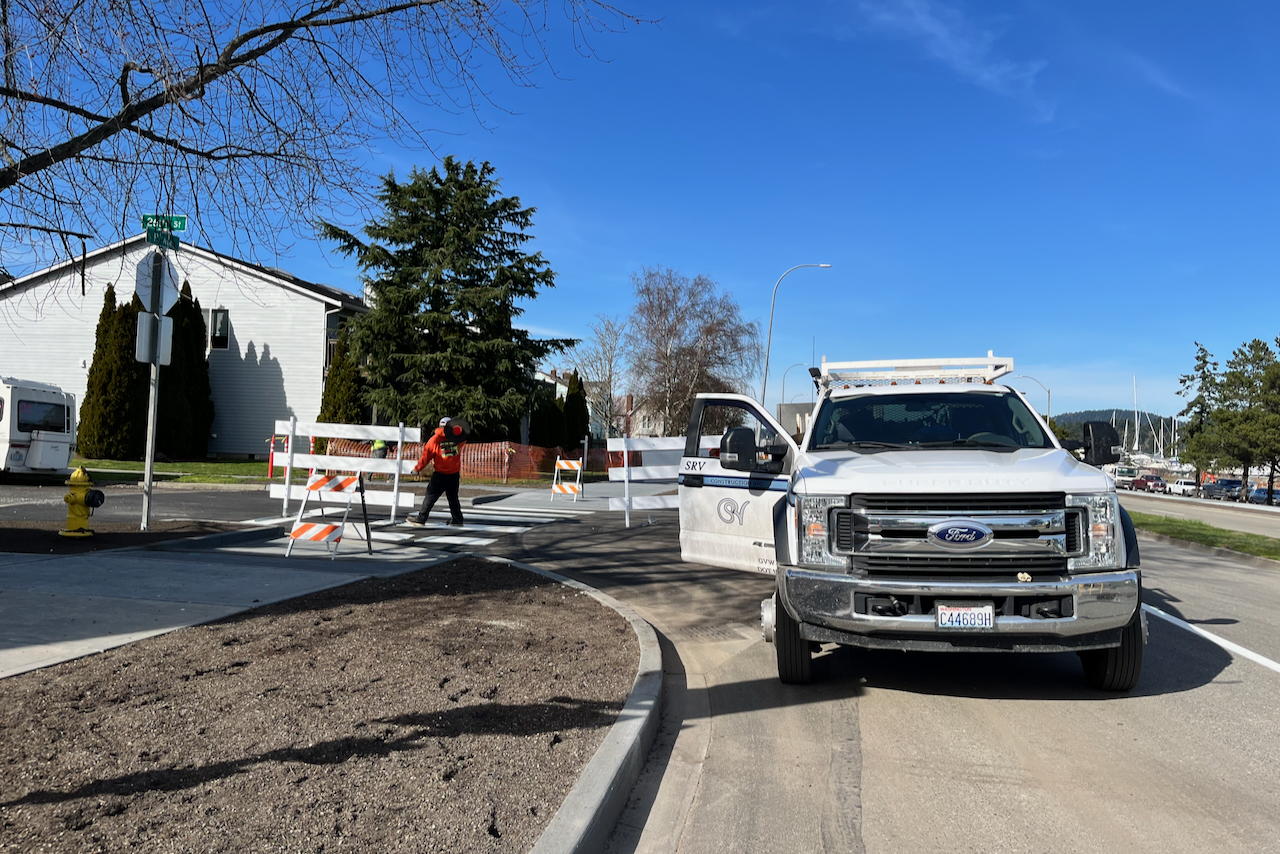

Crews remove barriers on R AvenueCity crews start removing barriers Friday afternoon. (Art Shotwell photo)

One of the key features includes sidewalks separated from motor vehicle traffic by landscaping.
Key improvements include:

  • Constructing a roundabout at the high-volume R Avenue and 30th Street intersection
  • New curb, gutter and sidewalks to 30th Street between R and Q avenues
  • New curb, gutter and sidewalks to Q Avenue between 29th and 32th streets
  • New curb, gutter and sidewalks to 29th Street between Q and Commercial avenues with a pedestrian crossing
  • 10-foot wide multi-use sidewalks between 22nd and 34th streets
  • Full median on R Avenue from 22nd Street to 34th Street
  • Enhanced stormwater management features
  • Street and pedestrian-scale lighting
  • ADA accessible street crossings

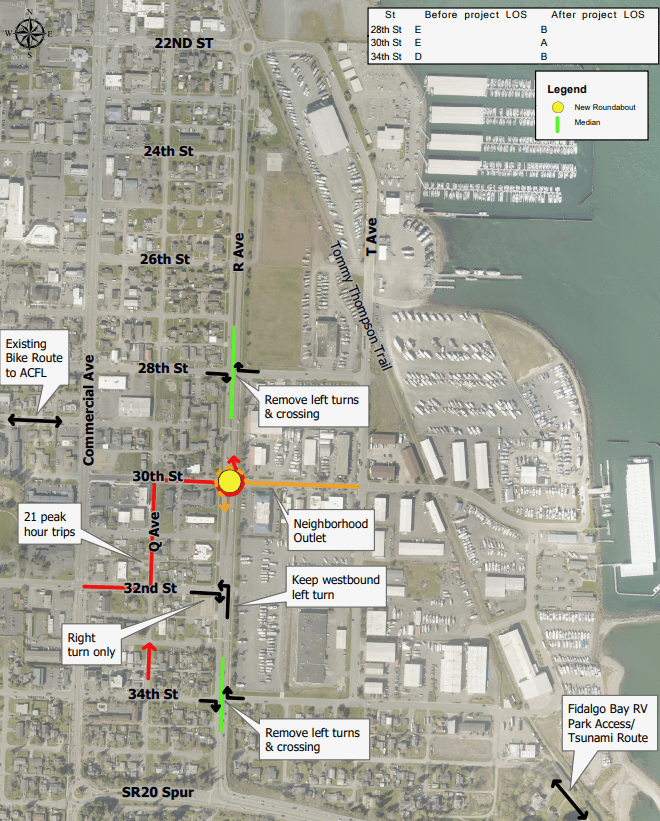

2024-0315-r-avenue3
Anacortes Public Works Department map

The city worked with consultant Transportation Solutions Incorporated on a city-wide traffic model to verify the Level of Service at selected intersections. The city is required to maintain a Level of Service C for all intersections.

The TSI report identified four failing intersections in Anacortes that are considered a Level of Service D. Three intersections are along the R Avenue corridor and the fourth is 32nd Street and Commercial Avenue.

The R Avenue Long Term Improvement Project has six phases of pedestrian and multi-modal projects to address the failing intersections along the R Avenue corridor in addition to other improvements.

These projects and improvements include a non-tranversable median, transit pull-outs, additional or improved sidewalks/walkways, bicycle wayfinding, new signals or roundabouts, traffic calming measures, additional street lighting, bicycle lanes, and physical buffers between pedestrians and walkways.

To date, four out of the six phases have been completed, utilizing various funding sources to construct each phase. The enhancements have included the 22nd Street roundabout; flashing pedestrian beacons near 23rd, 29th and 33rd streets; paving 34th Street; and the Highway 20 Spur re-channelization.
